6220.0 - Persons Not in the Labour Force, Australia, September 2013 Quality Declaration
ARCHIVED ISSUE Released at 11:30 AM (CANBERRA TIME) 26/03/2014  Final
   Page tools: Print Print Page Print all pages in this productPrint All

INTRODUCTION

1 Since the estimates in this publication are based on information obtained from occupants of a sample of dwellings, they are subject to sampling variability. That is, they may differ from those estimates that would have been produced if all dwellings had been included in the survey. One measure of the likely difference is given by the standard error (SE), which indicates the extent to which an estimate might have varied by chance because only a sample of dwellings was included. There are about two chances in three (67%) that a sample estimate will differ by less than one SE from the number that would have been obtained if all dwellings had been included, and about 19 chances in 20 (95%) that the difference will be less than two SEs. Another measure of the likely difference is the relative standard error (RSE), which is obtained by expressing the SE as a percentage of the estimate.

2 Due to space limitations, it is impractical to print the SE of each estimate in the publication. Instead, a table of SEs is provided to enable readers to determine the SE for an estimate from the size of that estimate (see table T1). The SE table is derived from a mathematical model, referred to as the 'SE model', which is created using data from a number of past Labour Force Surveys. It should be noted that the SE model only gives an approximate value for the SE for any particular estimate since there is some minor variation between SEs for different estimates of the same size.

CALCULATION OF STANDARD ERROR

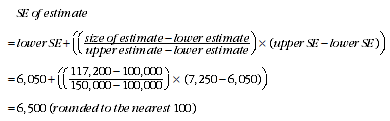

3 An example of the calculation and the use of SEs in relation to estimates of persons is as follows. Table 1 shows that the estimated number of people in Australia who were discouraged job seekers was 117,200. Since the estimate is between 100,000 and 150,000, table T1 shows that the SE for Australia will lie between 6,050 and 7,250 and can be approximated by interpolation using the following general formula:

Equation: Standard error of estimate formula

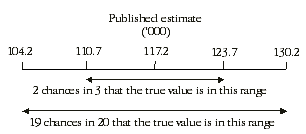

4 Therefore, there are about two chances in three that the value that would have been produced if all dwellings had been included in the survey will fall within the range 110,700 to 123,700 and about 19 chances in 20 that the value will fall within the range 104,200 to 130,200. This example is illustrated in the following diagram.

Diagram: Standard error of published estimate, two chances in three that the value is in this range

5 In general, the size of the SE increases as the size of the estimate increases. Conversely, the RSE decreases as the size of the estimate increases. Very small estimates are thus subject to such high RSEs that their value for most practical purposes is unreliable. In the tables in this publication, only estimates with RSEs of 25% or less are considered reliable for most purposes. Estimates with RSEs greater than 25% but less than or equal to 50% are preceded by an asterisk (e.g.*3.2) to indicate they are subject to high SEs and should be used with caution. Estimates with RSEs of greater than 50%, preceded by a double asterisk (e.g.**0.4), are considered too unreliable for general use and should only be used to aggregate with other estimates to provide derived estimates with RSEs of less than 25%.

PROPORTIONS AND PERCENTAGES

6 Proportions and percentages formed from the ratio of two estimates are also subject to sampling errors. The size of the error depends on the accuracy of both the numerator and the denominator. A formula to approximate the RSE of a proportion is given below. This formula is only valid when x is a subset of y.

Equation: Formula to calculate RSE of proportions

7 Considering the example from paragraph 3, of the 117,200 people who were discouraged job seekers, 55,000 or 46.9% were females. The SE of 55,000 may be calculated by interpolation as 4,700. To convert this to an RSE we express the SE as a percentage of the estimate, or 4,700/55,000=8.5%. The SE for 117,200 was calculated previously as 6,500 which converted to an RSE is 6,500/117,200=5.5%. Applying the above formula, the RSE of the proportion is:

    Equation: Formula to calculate RSE of proportions

    8 Therefore, the SE for the proportion of discouraged job seekers who were females is 3.0 percentage points (=(46.9/100)x6.5). Therefore, there are about two chances in three that the proportion of females who were discouraged job seekers was between 43.9% and 49.9% and 19 chances in 20 that the proportion is within the range 40.9% to 52.9%.

    DIFFERENCES

    9 Published estimates may also be used to calculate the difference between two survey estimates (of numbers or percentages). Such an estimate is subject to sampling error. The sampling error of the difference between two estimates depends on their SEs and the relationship (correlation) between them. An approximate SE of the difference between two estimates (x–y) may be calculated by the following formula:

    Equation: Formula to calculate the standard error of the difference between two estimates

    10 While this formula will only be exact for differences between separate and uncorrelated characteristics or subpopulations, it is expected to provide a good approximation for all differences likely to be of interest in this publication.

      STANDARD ERRORS



      T1 standard errors of estimates
      NSW
      Vic.
      Qld.
      SA
      WA
      Tas.
      NT
      ACT
      SE
      RSE
      Size of Estimate (persons)
      no.
      no.
      no.
      no.
      no.
      no.
      no.
      no.
      no.
      %
      100
      180
      150
      200
      170
      170
      110
      80
      120
      140
      140.0
      200
      300
      230
      330
      250
      260
      160
      110
      210
      240
      120.0
      300
      390
      290
      440
      310
      330
      200
      130
      270
      320
      106.7
      500
      530
      400
      600
      400
      440
      250
      170
      370
      460
      92.0
      700
      650
      480
      730
      470
      520
      290
      200
      430
      580
      82.9
      1,000
      800
      580
      900
      560
      620
      340
      240
      500
      730
      73.0
      1,500
      990
      710
      1 120
      670
      760
      400
      290
      580
      940
      62.7
      2,000
      1 150
      820
      1 300
      760
      860
      440
      330
      630
      1 120
      56.0
      2,500
      1 300
      900
      1 450
      850
      950
      450
      350
      650
      1 250
      50.0
      3,000
      1 400
      1 000
      1 600
      900
      1 050
      500
      400
      700
      1 400
      46.7
      3,500
      1 500
      1 050
      1 700
      950
      1 100
      550
      450
      750
      1 500
      42.9
      4,000
      1 600
      1 150
      1 800
      1 000
      1 150
      550
      500
      750
      1 650
      41.3
      5,000
      1 800
      1 250
      2 000
      1 100
      1 250
      600
      550
      850
      1 800
      36.0
      7,000
      2 100
      1 450
      2 300
      1 250
      1 450
      700
      750
      1 000
      2 150
      30.7
      10,000
      2 400
      1 650
      2 650
      1 400
      1 600
      850
      1 000
      1 300
      2 500
      25.0
      15,000
      2 800
      1 950
      3 050
      1 650
      1 900
      1 050
      1 400
      1 700
      3 000
      20.0
      20,000
      3 150
      2 150
      3 350
      1 900
      2 150
      1 200
      1 800
      2 000
      3 350
      16.8
      30,000
      3 600
      2 500
      3 900
      2 350
      2 700
      1 500
      2 450
      2 450
      3 850
      12.8
      40,000
      4 000
      2 750
      4 400
      2 750
      3 200
      1 750
      3 000
      2 750
      4 250
      10.6
      50,000
      4 350
      3 000
      4 850
      3 100
      3 650
      1 950
      3 500
      2 950
      4 600
      9.2
      100,000
      6 050
      4 350
      7 150
      4 450
      5 350
      2 700
      5 450
      3 350
      6 050
      6.1
      150,000
      7 700
      5 600
      9 050
      5 350
      6 600
      3 200
      6 900
      3 350
      7 250
      4.8
      200,000
      9 200
      6 650
      10 600
      6 050
      7 600
      3 600
      . .
      . .
      8 300
      4.2
      300,000
      11 600
      8 450
      13 050
      7 100
      9 100
      4 200
      . .
      . .
      10 100
      3.4
      500,000
      15 000
      11 350
      16 500
      8 550
      11 300
      5 000
      . .
      . .
      13 200
      2.6
      1,000,000
      20 050
      16 750
      21 650
      10 600
      14 600
      . .
      . .
      . .
      19 550
      2.0
      2,000,000
      24 950
      24 200
      26 850
      12 650
      18 250
      . .
      . .
      . .
      28 300
      1.4
      5,000,000
      30 000
      38 550
      32 900
      . .
      . .
      . .
      . .
      . .
      40 800
      0.8
      10,000,000
      31 800
      53 850
      . .
      . .
      . .
      . .
      . .
      . .
      49 000
      0.5
      15,000,000
      . .
      . .
      . .
      . .
      . .
      . .
      . .
      . .
      52 550
      0.4
      . . not applicable

      T2 levels at which estimates have a relative standard errors of 25% and 50%(a)
      NSW
      Vic.
      Qld
      SA
      WA
      Tas.
      NT
      ACT
      Australia
      Percentage
      no.
      no.
      no.
      no.
      no.
      no.
      no.
      no.
      no.
      RSE of 25%
      9 400
      5 000
      10 900
      4 100
      5 100
      1 600
      900
      2 700
      10 100
      RSE of 50%
      2 700
      1 300
      3 300
      1 200
      1 500
      500
      200
      1 000
      2 600
      (a) Refers to the number of people contributing to the estimate
